Heavy Civil & HighwayUnited States

Daniel Angos Villegas, PMP®

Heavy Civil • Field record in Ecuador, 2007–2025

For 15+ years I built highways, site pads and pavements in Ecuador, from the crusher to the final lift. Today I am based in the United States.

Email me
  • $83.5Macross 34 public and private contracts in Ecuador
  • 15+ yrsin heavy civil, 11+ of them as chief superintendent and project manager
  • 150+people led on site, from crews to engineers

Daniel Angos VillegasPMP®

Career path

  1. Field & Resident Engineer
  2. Assistant Superintendent
  3. Superintendent
  4. Chief Superintendent
  5. Project Manager
PMP certification badgePMP® No. 4047085Valid through Feb 2028Procore certificationsOSHA 30-Hour Construction Training

United States

Field record: Ecuador, 2007–2025

01Today

Current certifications.

  • Certified

    Procore certifications

    Superintendent (Oct 2026) and Field Worker (Nov 2026), issued by Procore Technologies.

  • Safety

    OSHA 30-Hour Construction

    OSHA Outreach Training Program, completed in Nov 2026 through 360training.

02Profile

In Ecuador, I learned to run the work and the numbers.

I started on excavators and a rock crusher while finishing engineering school, then grew on site one level at a time: field and resident engineer, assistant superintendent, superintendent, chief superintendent and project manager, on self-perform public and private work.

In Ecuador, I was responsible for schedule, cost, pay estimates, quality and safety, from mobilization to closeout. Army service taught me safety discipline and how to decide under pressure.

Career path

Every step, earned on site.

  1. Field & Resident EngineerInspection, quantities and pay estimates, on site every day.
  2. Assistant SuperintendentCrews, equipment and daily production, next to the superintendent.
  3. SuperintendentCertified by MTOP in 2013: schedule, quality and safety in the field, shift after shift.
  4. Chief SuperintendentSuperintendents and work fronts in nine provinces: crushing, plants and paving crews.
  5. Project ManagerSchedule, cost, pay estimates and closeout: 34 contracts, $83.5M.

03By the numbers

The field record, station by station.

  1. 113units

    fleet managed: 36 transport vehicles and 77 machines, including 3 crushing plants, 2 concrete plants and 1 asphalt plant

  2. 9provinces

    with simultaneous work fronts

  3. ~66,000cy

    of paving concrete (about 50,000 m³) slipformed with a GOMACO Commander III on a 15.5-mile corridor, as a subcontractor

  4. ~105cy/h

    largest concrete batch plant supervised (80 m³/h)

  5. 5centers

    forensic facilities built at the same time in five provinces, under one QA/QC standard

04Featured project

Day 56 of 60. Four lanes. The road never closed.

Manuel Córdova Galarza Avenue, Quito • Ministry of Transportation and Public Works (MTOP) • $5.4M

My role: Project Director and Chief Superintendent

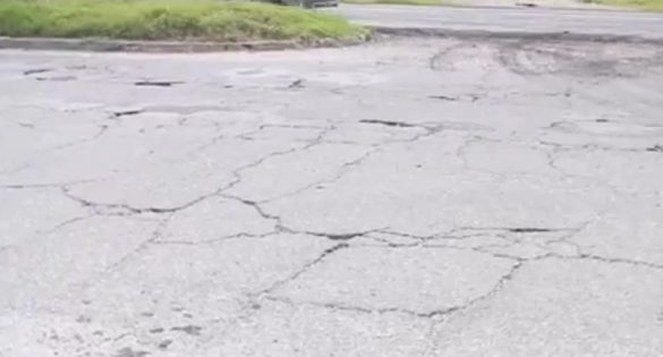

Alligator cracking and failed trench repairs
01 Before • Alligator cracking and failed trench repairs
Full-depth reclamation (FDR) train

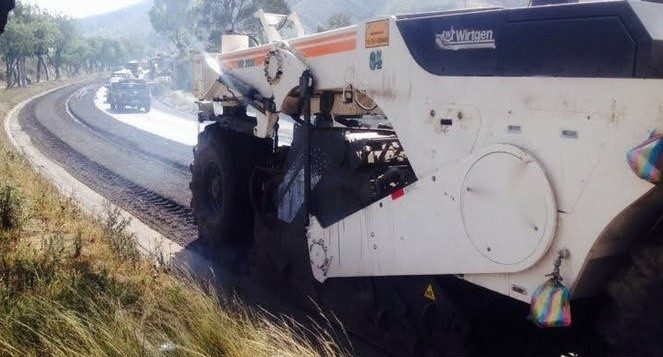

02 Reclaim • Full-depth reclamation (FDR) train
Dump truck feeding hot-mix asphalt into a paver while the crew works alongside

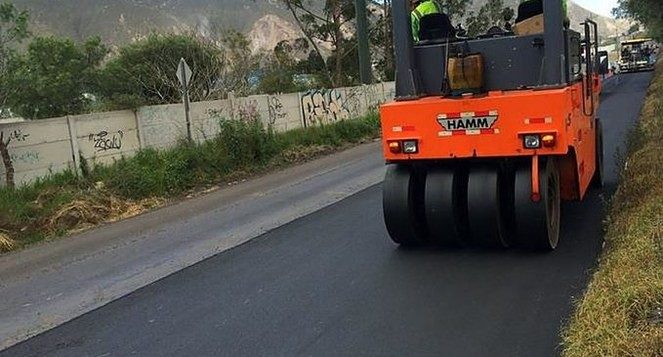

03 Surface • 3-inch hot-mix asphalt

Day 56 of 60

The problem

A four-lane urban avenue with no viable detour, and 6 to 9 inches of asphalt that was alligator-cracked, rutted and patched over failed trenches.

The method

Full-depth reclamation (FDR) with a reclaimer, asphalt emulsion and rejuvenating agent, building a stabilized base under a 3-inch hot-mix surface. Traffic kept moving with phased lane closures and contraflow.

The result

Finished early: provisional acceptance (akin to substantial completion) was requested with four days to spare, after absorbing about 8.8% added scope with no time extension.

Watch the project video (opens in a new tab)

04Featured project 2 · Deep foundations

Tremie concrete for bridge piles. Produced through floods and lahars.

Upano River bridges, Macas, Ecuador • Ministry of Transportation and Public Works (MTOP) project • 2023–2024

My role: Project Director and Heavy Civil Manager (subcontractor consortiums)

Steel pile casings on river gravel, with a rotary drilling rig behind and a vibratory hammer hanging from a crane

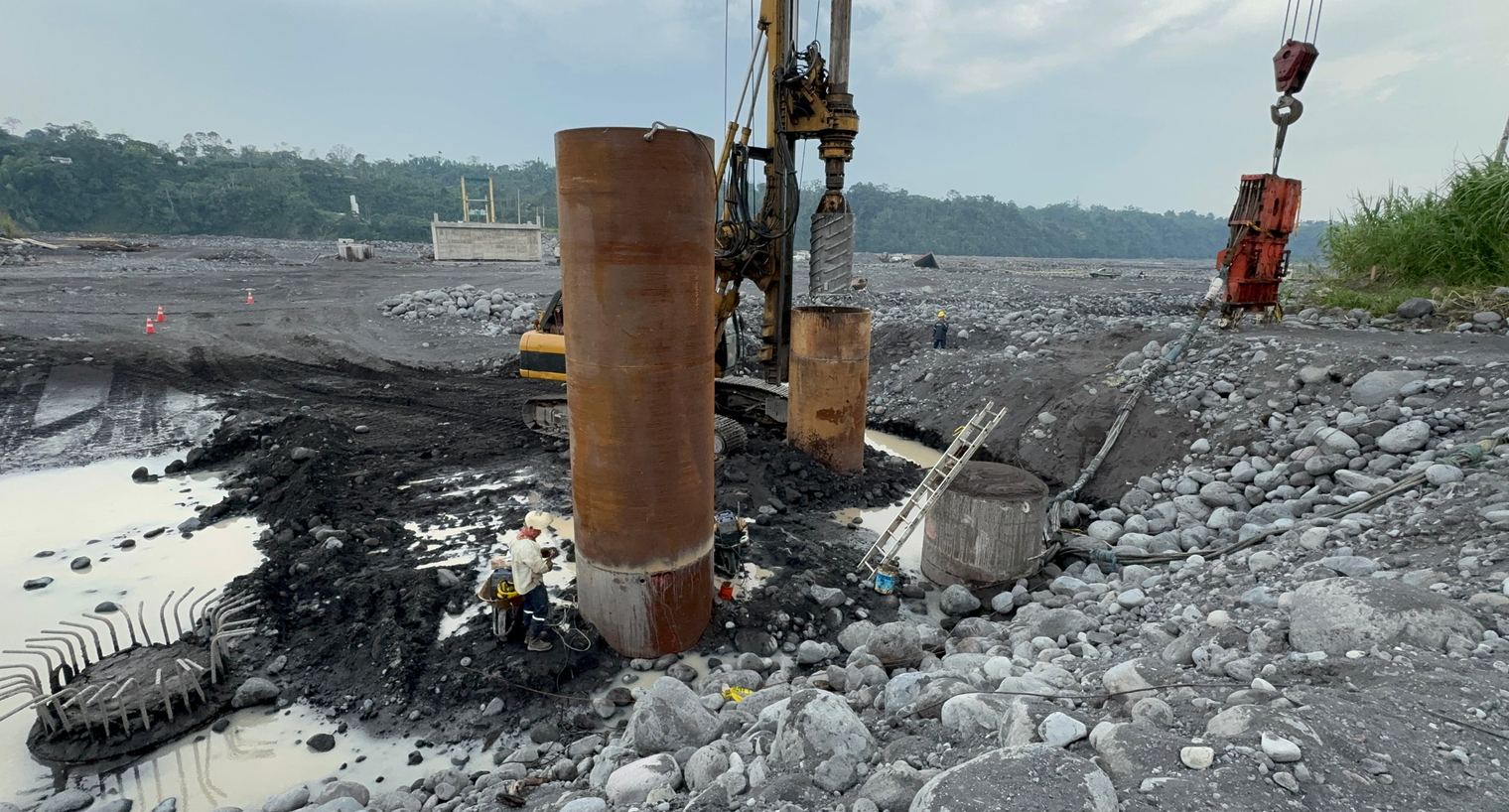

01 Drill • Steel casings and drilling rig (another contractor)

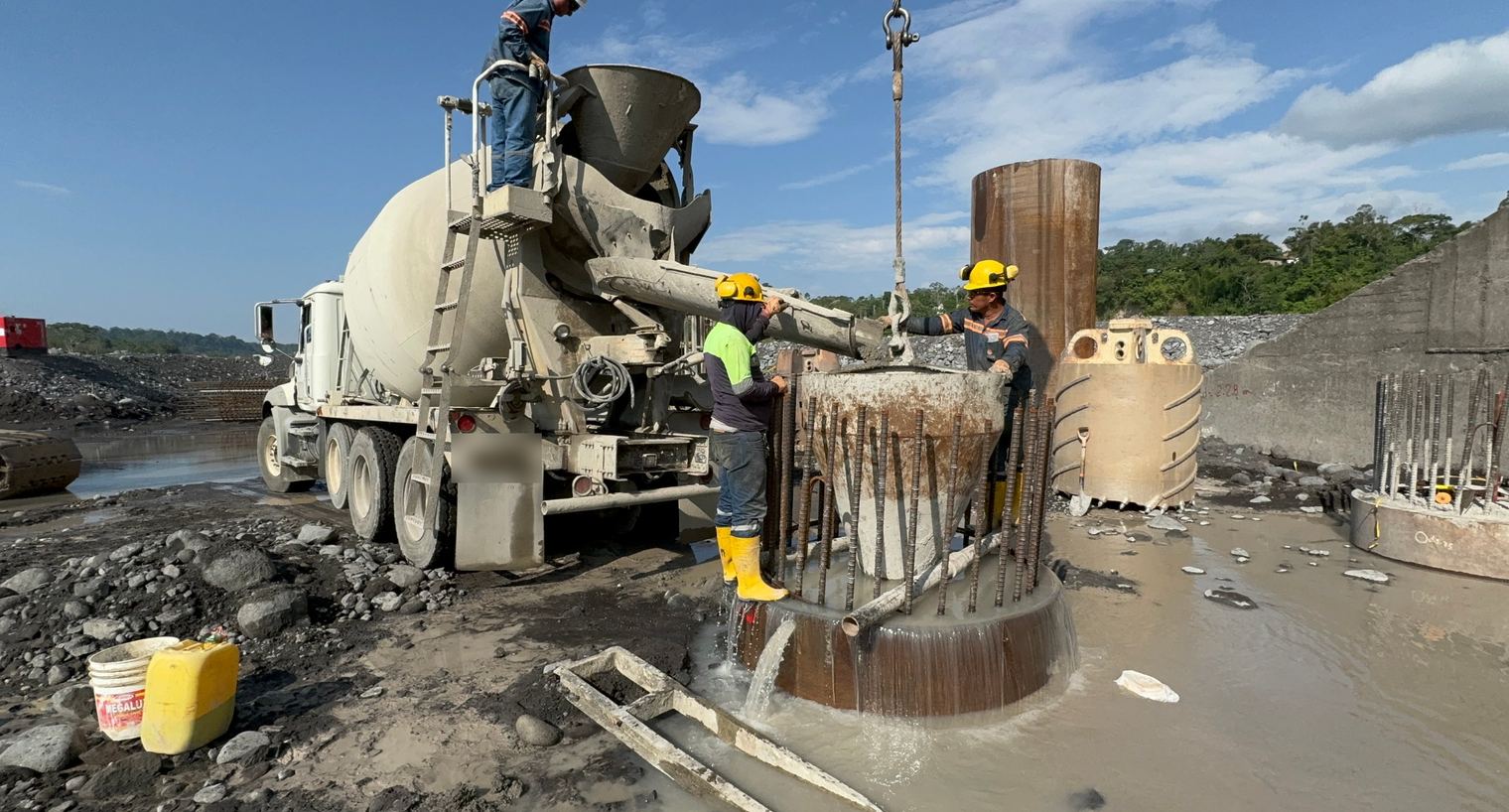

Mixer truck discharging into a tremie hopper set inside the pile cage, with displaced water spilling over the casing
02 Tremie • Concrete goes in; displaced water spills over

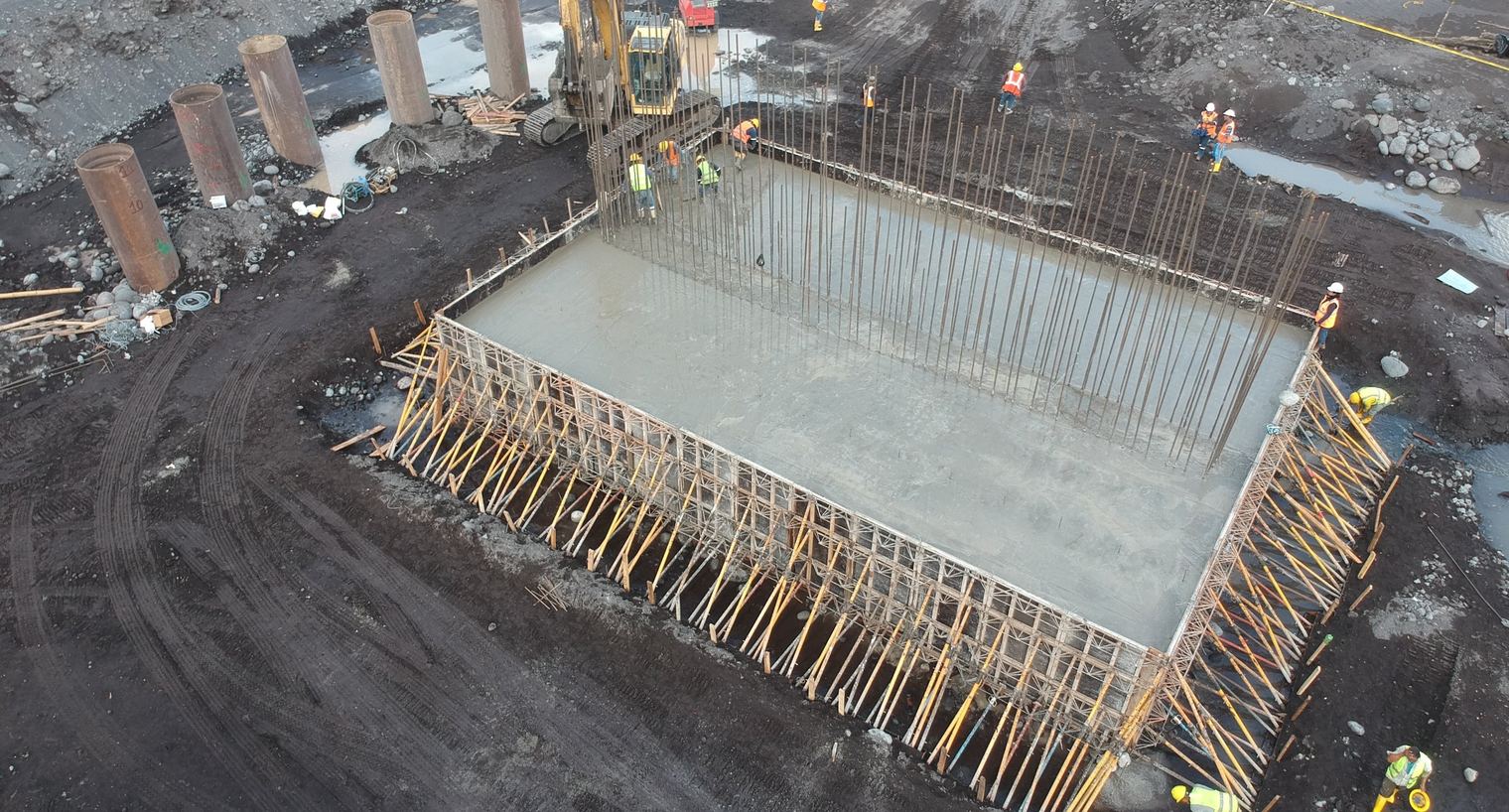

Aerial view of a pile cap being poured, with a row of steel pile casings beside it
03 Pile cap • Cap pour next to a row of pile casings

Drilling by others

The problem

Bridge piles drilled through river gravel and boulders, below the water table, on a river hit by flash floods and volcanic lahars. The piles were poured under water, by tremie. Once a tremie pour starts, the concrete has to keep coming.

Our scope

Our concrete consortium produced and supplied the high-strength tremie concrete and ran its QA/QC. Another contractor drilled the piles. Mixer trucks discharged straight into the tremie hopper, and the concrete rose from the bottom of the shaft, pushing the water out over the top of the casing. Our consortiums' scope also covered abutments, decks, concrete structures and hydraulic protection.

The result

Concrete production kept running through floods, river currents and lahars. The project is complete and has been handed over.

See it in my projects

See how the concrete was produced

05The edge

Aggregate production, from the crusher up.

I’ve run quarry, river and recycled material through tracked Kleemann and Powerscreen plants, with crews and fuel burn planned around plant output.

Loader feeding a Kleemann crusher

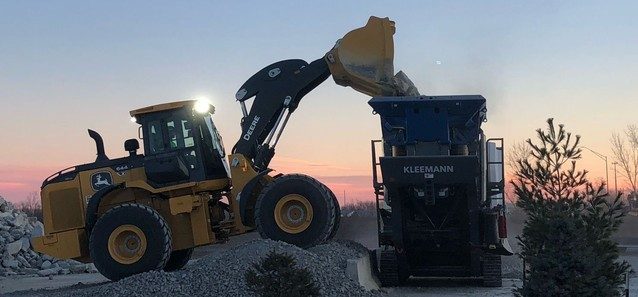

01 • Loader feeding a Kleemann crusher
Wheel loader and excavator feeding a tracked Kleemann plant

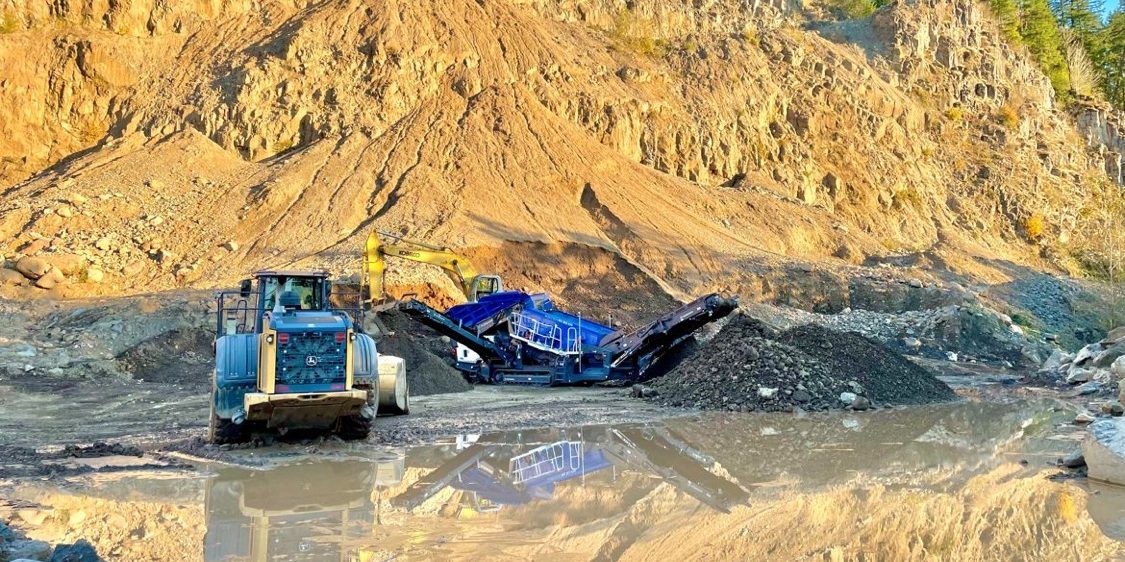

02 • Wheel loader and excavator feeding a tracked Kleemann plant

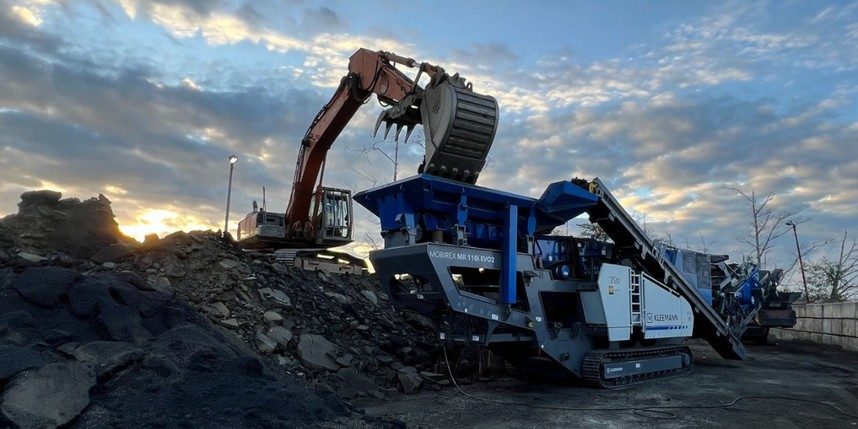

Kleemann MOBIREX impact crusher
03 • Kleemann MOBIREX impact crusher
Kleemann cone crusher and screens in closed circuit

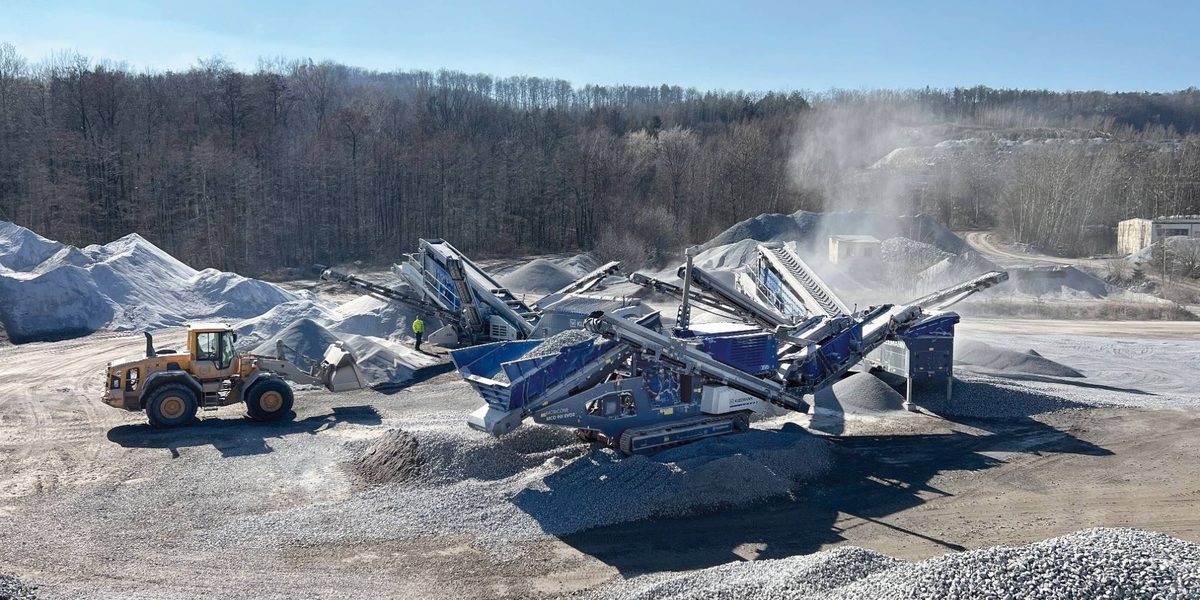

04 • Kleemann cone crusher and screens in closed circuit
Tracked crusher stockpiling aggregate

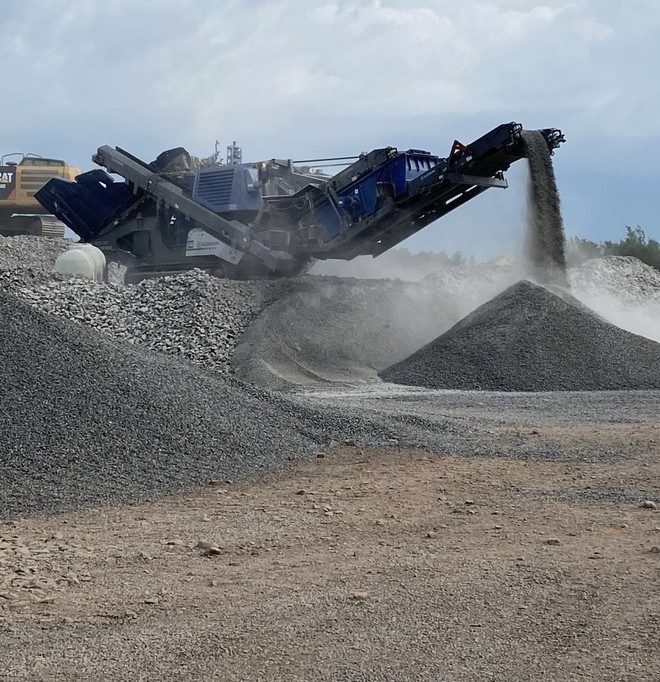

05 • Tracked crusher stockpiling aggregate

See the projects

06Concrete production

Bridge concrete, from the batch plant to the pour.

On the Upano River bridges, a Ministry of Transportation and Public Works (MTOP) project, I directed the subcontractor consortiums that produced the concrete and built the concrete works of every bridge structure: pile caps and foundations (piles drilled by another contractor), substructure, superstructure decks, riverbank protection and ancillary works.

Featured video

Underwater concrete on the Upano River

Under a minute, narrated in English: the batch plant on site, quality control on every load, and the tremie concrete we supplied for the bridge piles, placed underwater.

Watch on YouTube (opens in a new tab)
  • ~5,000 and ~7,100 psiSpecified compressive strength f′c: 350 and 500 kg/cm² (34 and 49 MPa)
  • 90% at 7 days7-day compressive strength reached 90% of f′c
  • ~105 cy/hAltron batch plant on site (80 m³/h)
  • TremieTremie concrete supplied for bridge piles, placed underwater

f′c = specified compressive strength (ACI notation). Our concrete consortium ran its own QA/QC.

Read the Upano River case

Let’s connect.

To talk about heavy civil work, email is the best way to reach me.

15-second reel

15-second reel with background music. On-screen text: Heavy civil, 15+ years in the field. From field engineer to project manager: field engineer, assistant superintendent, superintendent, chief superintendent, PM. $83.5M across 34 contracts in Ecuador. 113-unit fleet with 3 crushing plants. About 66,000 cy of slipformed paving concrete. 11+ years as chief superintendent and PM. Day 56 of 60, four lanes, the road never closed; project director and chief superintendent. Daniel Angos Villegas, PMP number 4047085, valid through February 2028, Heavy Civil and Highway, United States. gerencia@ingdanielangosv.com, ingdanielangosv.com.
